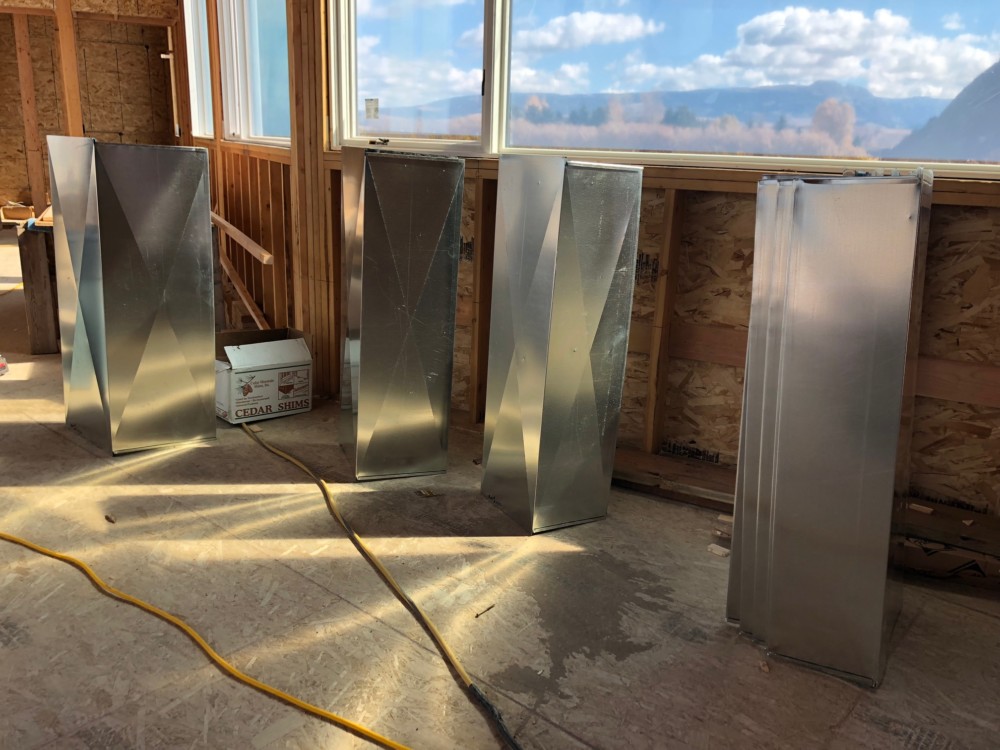

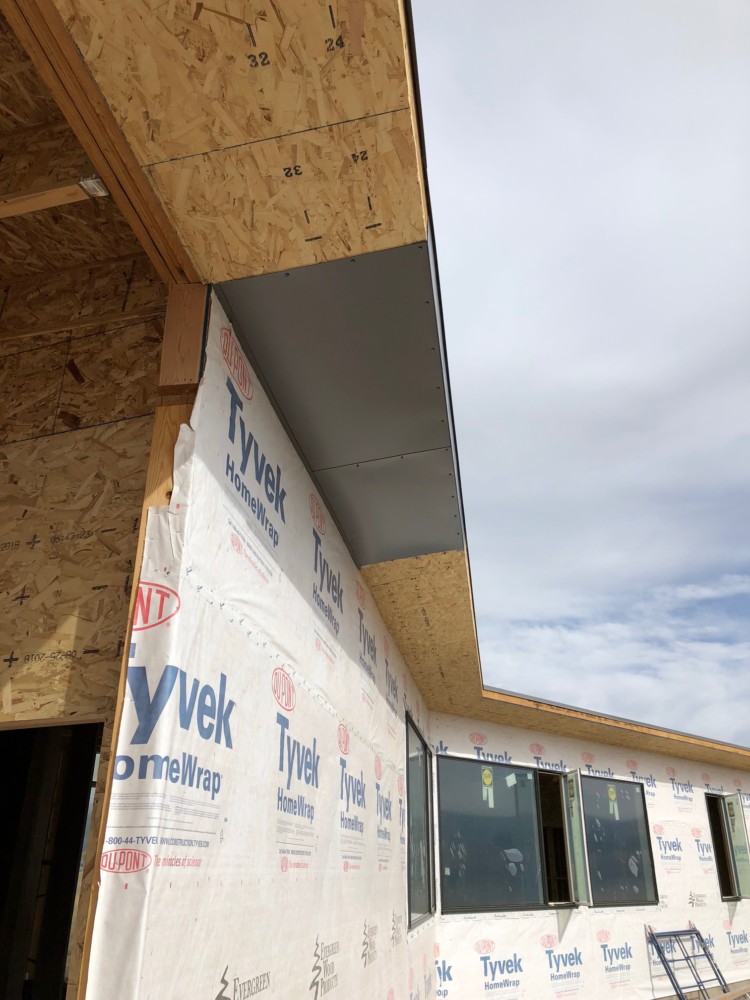

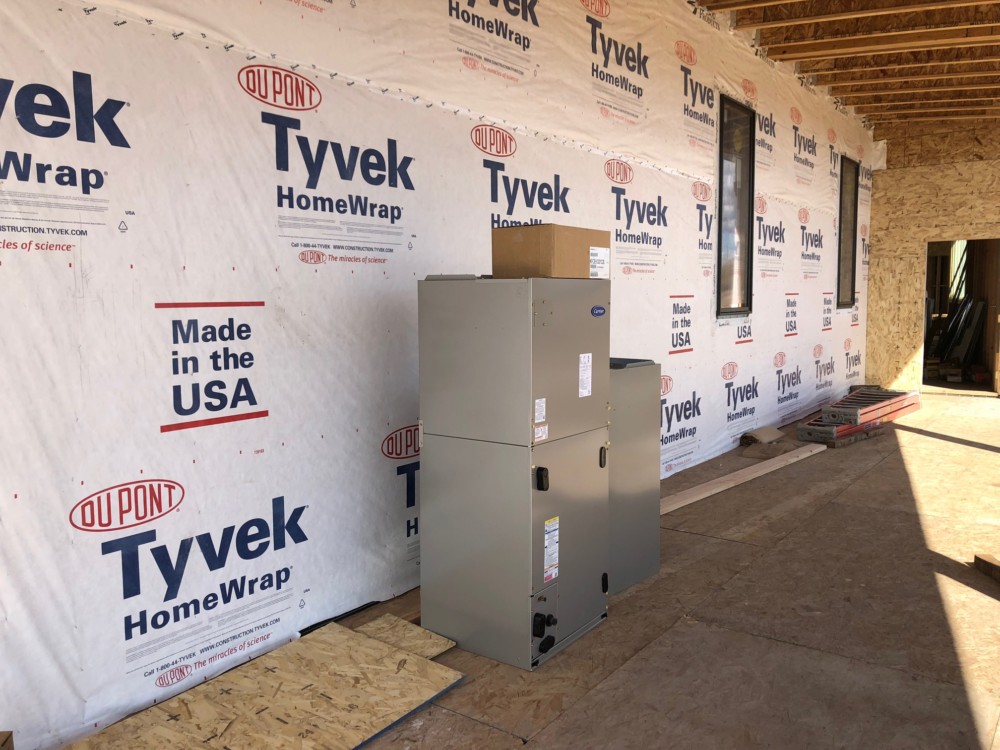

This week the electrician, plumber and HVAC mobilized for rough-in. The plumber installed the waste/vent lines, and the electrician began boxing out for outlets, switches, and light fixtures. The HVAC crew cut most of their supply/return ducts in the floor, and delivered the bulk of their duct work to the site. They also set both furnaces in the crawlspace. Salt River Roofing had the metal roof panels delivered and rolled on Wednesday, so they are waiting for an install crew to free up, probably within the next few weeks. Wade Metalworks installed the mock-up for the soffit and fascia for approval, and is ready for final measure and install. The septic tank was also delivered to the site in case the excavator is able to install the leach field and septic tank this fall before the snow flies.
